Photos and Notices Amalgamated Houses

Men working, red cable plugged in


On doorknob evening March 1, 2017

February 24, 2017 noticed that 17H is vacant, April 12, 2017 Apt 17H still vacant

Bldg 8, repairs to sidewalk, photographed Feb 25, 2017 morning

Alvin Brown no longer Director of Maintenance

Holiday Lights 2016

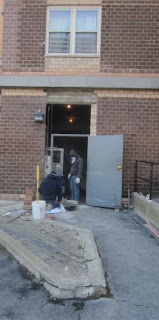

Tower 1 repairs to a back door.
Tower 1 more repairs back door.
April 14, 2017

Instructions
Can you find the bell symbol?




Entrance to Tower 2 4:30 pm October 28, 2015





Weather has been great, cannot be given as a reason for the delay.  What high standards?  cooperators need an explanation.  This is a one month delay.  What will the usage and maintenance guidelines be?

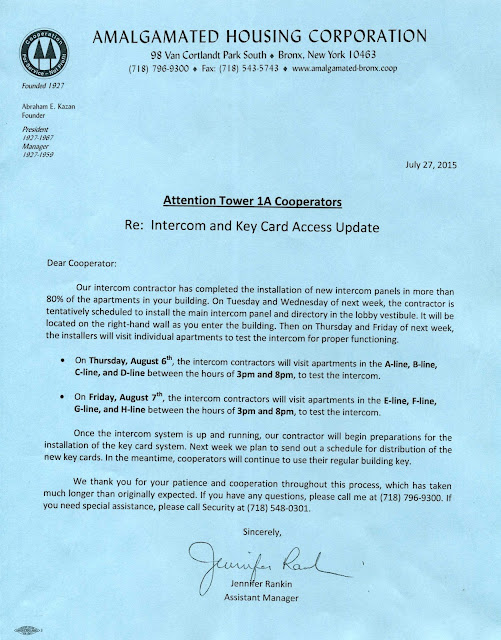

Incorrect Notice








Lobby April 2, 2015, particle board installed

May 2, 2015, Saturday work being done on outside of the building
May 1, 2015 ever so slowly the work continues on the wiring.  No approximate end date has been given.
April 14, 2015 morning, observed no work being done
April 13, 2015 Early afternoon I saw two porters cleaning the first floor (lobby)  I observed one man wiping down the mailbox exteriors.
April 9, 2015 men working on lobby
April 8, 2015 one man working on windows around inner doors
April 7, 2015 lobby two men in the morning, one taking measurements, the other with notes.  Apparently evaluating the status of the work.
April 6, 2015 lobby of Tower 1 worked on
April 2, 2015 lobby of Tower 1 worked on, doors open because of strong chemical smell
April 1, 2015 No work done on lobby of Tower 1
March 31, 2015 No work done on lobby of Tower 1




Lobby, March 11, 2015 5 pm



I won't have to call because the work started today on Martin Luther King Day.  I have a towel along the bottom.  The notice was delivered after 5 pm on Friday.
Dust Mitigation F Line Tower 1












August 18, 2014, an update by Jennifer Rankin was at the doors of the Tower 1 cooperators. The previous update was on August 5. I don't have a scanner at the moment. These are the two relevant items copied verbatim:
 A Line and B Line Demolition of curbs continues, from the 12th floor of the building downward. It is expected to completed on or about August 29th.
 E Line, F Line and G Line Demolition is now complete, and rebar is being repaired and installed where needed. Form work will begin once the rebar work is finished. **************************************************************
 Note the lack of dates for completion of the rebar work on the E, F and G lines
August 15, 2014 On the G line of Tower 1 it looks like on each balcony, a small window has been cut in the plywood, so some natural light can get in the apartment.








June 25, 2014 plywood on balcony, line F Tower 1

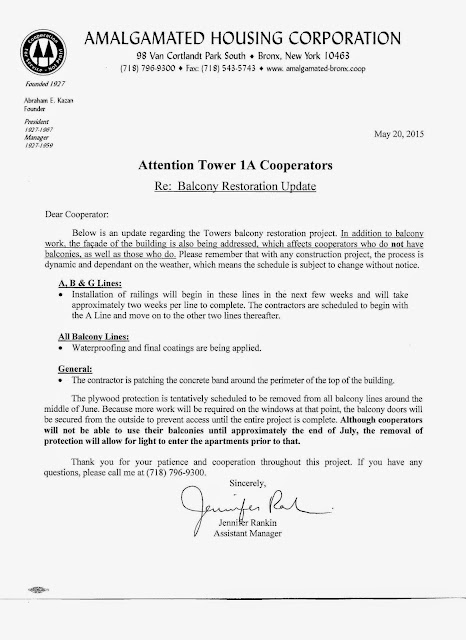

May 20 Information Meeting
Saturday, April 25, 2015 work on balconies of Tower 1 including mine.





May 2, 2014, dumpster ready for refill

April 30, 2014, dumpster more than half full

No comments:
